Building a Custom Home in Dewey Beach

Building a custom home in Dewey Beach means designing for a narrow lot inside a FEMA flood zone, elevating the lowest floor a full two feet above base flood elevation, and scheduling the work around a summer window that shuts down pile driving from Memorial Day to Labor Day. The constraints come first. The design follows them.

Dewey is roughly a mile long and, in places, only a few hundred feet wide — ocean on one side, Rehoboth Bay on the other. That geography is the appeal, and it is also why a build here behaves differently from one two miles inland. Almost every buildable lot in town sits in a Special Flood Hazard Area under FEMA community number 100056.

Why a Dewey Beach Build Starts With the Lot, Not the Plan

On an inland parcel, a family usually starts with a floor plan they love and adjusts it to the site. Building a custom home in Dewey Beach reverses that order. The lot dictates the footprint, the flood zone dictates the first floor height, and the zoning district dictates how much of the lot the house can occupy. Once those three answers are on paper, the design envelope is largely defined.

Three things need answering before anyone draws:

  • Which flood zone the lot sits in. The town contains both VE zones — coastal high-hazard areas exposed to wave action — and AE zones behind them. Different chapters of the code govern each, and they produce structurally different houses.
  • Which zoning district applies. Residential districts include NR (Neighborhood Residential), RR (Resort Residential) and PR (Planned Residential), each with its own bulk standards for lot area, setbacks and height.
  • The base flood elevation at that address. BFE varies across town, and it is the number every vertical decision is measured from.

It is why the first of our 5 Simple Steps is a conversation about the site rather than a portfolio review. A gorgeous plan that cannot legally fit the lot is an expensive detour.

How High Does a New Dewey Beach Home Have to Be Elevated?

Dewey Beach requires two feet of freeboard above base flood elevation. In AE zones the lowest floor, including any basement, must sit at or above BFE plus two feet. In VE zones the standard is stricter: the bottom of the lowest horizontal structural member — the girder, not the finished floor — must be at or above BFE plus two feet.

  • The town adopted the two-foot standard in October 2024, with the rule taking effect the following spring.
  • It applies to new construction and to improvements exceeding fifty percent of the structure’s appraised value.
  • Electrical service and mechanical equipment must also be elevated to BFE plus two feet.
  • Freeboard is measured from BFE, so two identical houses on two different Dewey lots can finish at different heights.

Freeboard is not bureaucratic padding. It buys margin against surge that runs higher than the mapped flood, and it lowers premiums — see our overview of flood insurance for a Delaware beach home.

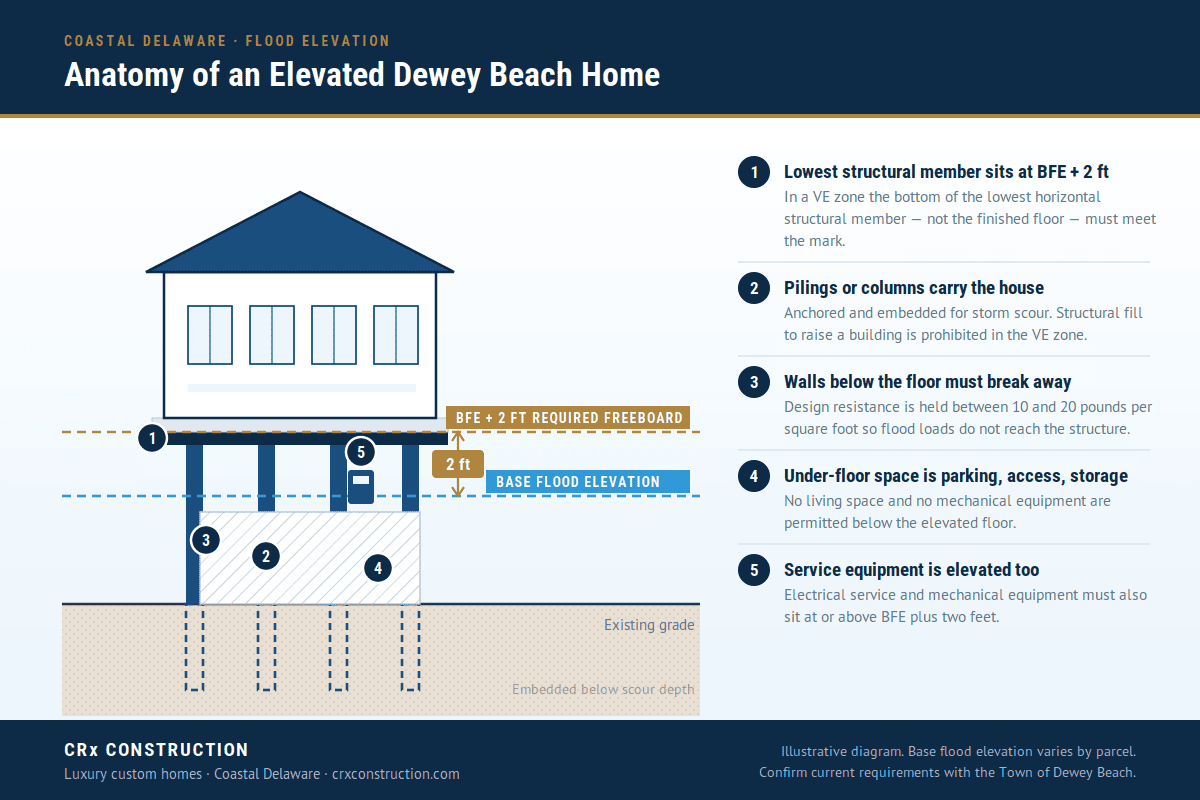

Diagram of an elevated Dewey Beach home showing grade, base flood elevation, two feet of freeboard, breakaway walls and pile foundation
How the two-foot freeboard rule stacks up on a Dewey Beach lot. Illustrative; confirm your site’s base flood elevation with the town.

Foundations: Pilings, Breakaway Walls and Why Fill Is Not an Option

In a VE zone the house is not built on the ground; it is built above it. Town code requires structures to be supported on pilings or columns and adequately anchored to them, with pile embedment calculated for the depth soil will scour away during a storm. The pile layout is engineered, not a rule of thumb.

Two details surprise most first-time coastal builders. Placing structural fill to raise a building is expressly prohibited in the coastal high-hazard area — you cannot import dirt to solve an elevation problem. And anything enclosed underneath the elevated floor has to be designed to fail: walls below the lowest floor are permitted only if they break away under flood loads without taking the structure with them, with design resistance held between ten and twenty pounds per square foot.

That enclosed area is limited to parking, building access and storage — no living space, no mechanical equipment. In AE zones the parallel requirement is flood venting: at least two openings on different sides of each enclosed area, one square inch of net opening per square foot enclosed, with the bottom of each opening no more than a foot above grade. Weighing whether an existing cottage can be saved or should come down? These rules usually drive the answer, as our piece on renovating versus tearing down explains.

What Elevation Does to the Floor Plan

Lifting the living level ten or twelve feet off the ground changes the house above it, not just the structure below. Stairs become a real design problem: a single run from grade to the main level eats footprint and street presence, so most well-resolved Dewey homes break the climb with a landing, tuck the run alongside the house, or place an elevator in the core. On a narrow lot, an elevator shaft often costs less usable area than a compliant stair.

The ground level becomes an amenity rather than dead space. Covered parking, an outdoor shower, board storage and a shaded gathering area all live comfortably under an elevated house when the columns, screening and lighting are designed rather than left over.

Views invert too. Because the main floor already sits high, the second story often gets the ocean or bay sightline, which is why so many coastal plans put the kitchen and great room on top and the bedrooms below. It works, but it should be a deliberate choice made early. Our notes on indoor-outdoor living in Delaware cover how the decks around that upper level get planned alongside it.

Build Sequence

How a Dewey Beach Project Actually Runs

The phases are familiar to anyone who has built before. The constraint attached to each one is specific to Dewey.

# Phase What Happens The Dewey Constraint
1 Site feasibility Survey, flood zone determination, district check BFE and bulk standards define the envelope before design begins
2 Schematic design Footprint, massing, floor plan, elevations Height is budgeted from BFE plus two feet, not from grade
3 Engineering Structural design, pile layout, flood venting VE lots need pile-supported design; AE enclosures need rated openings
4 Permitting Building permit application and town review Permits run one year and may be renewed once if filed before expiration
5 Site work and piles Pile driving, utilities, stormwater No pile driving from the Thursday before Memorial Day to the Tuesday after Labor Day
6 Frame and dry-in Structure, roof, windows, weather barrier No work before 8:00 a.m. or after 6:00 p.m.; no Sundays or state holidays
7 Finishes Interior trim, cabinetry, tile, exterior cladding Material staging is restricted from May 15 through September 15
8 Closeout Final inspections and certificate of occupancy An elevation certificate documents finished height for insurance
See how long a Delaware custom home typically takes · CRx Construction, Rehoboth Beach, DE

Can You Build in Dewey Beach During the Summer?

Partly. General construction continues through the season, but the town restricts when and how it happens. Pile driving is prohibited from 6:00 p.m. on the Thursday before Memorial Day until 8:00 a.m. on the Tuesday after Labor Day, and daily work hours are limited year-round.

  • No construction activity between 6:00 p.m. and 8:00 a.m. on any day.
  • Saturday work is allowed from 9:00 a.m. to 6:00 p.m. only between September 16 and May 14.
  • Sundays and state holidays are off entirely.
  • Between May 15 and September 15, materials must be stored so they do not obstruct pedestrian or vehicle traffic, with barriers and lighting maintained.

The consequence is a schedule built backward from Memorial Day. If the piles are not in the ground by mid-May, the foundation waits until fall, and that single missed window can push completion by a full season. Filing the permit set early is the whole game.

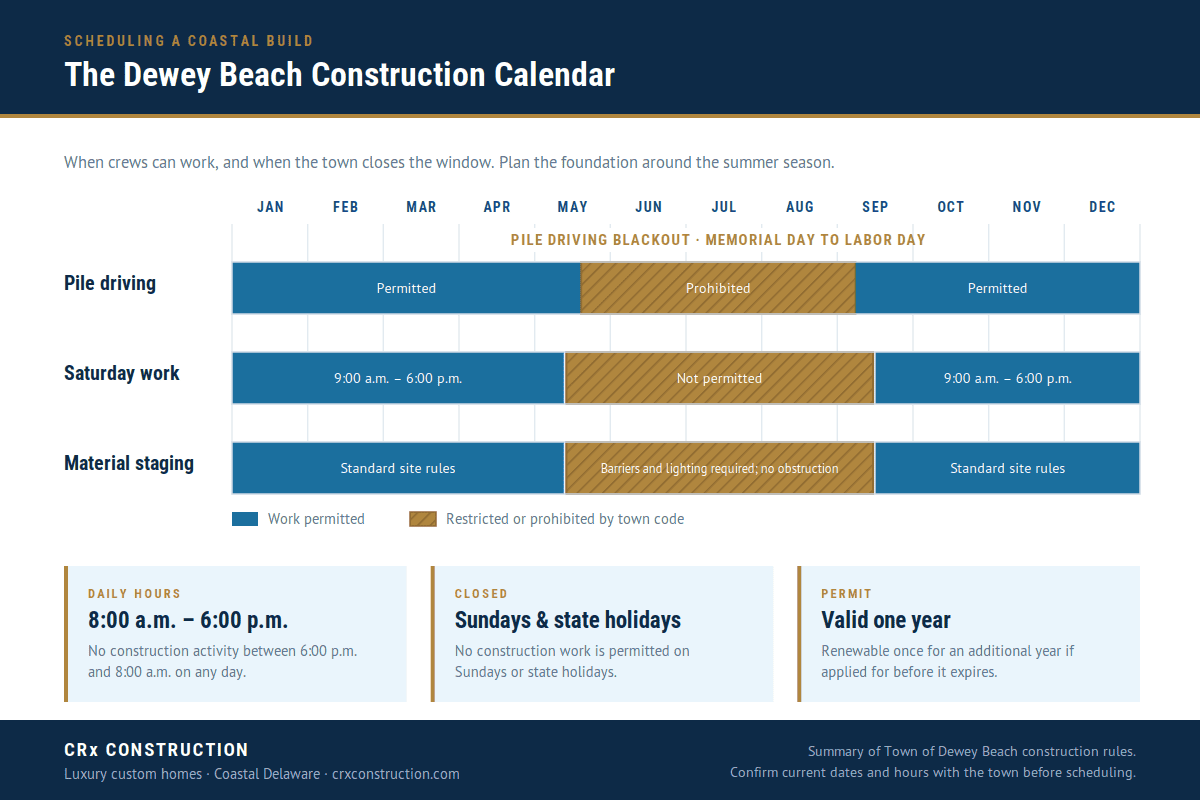

Dewey Beach construction calendar showing pile driving blackout between Memorial Day and Labor Day, permitted daily work hours and seasonal material staging limits
The Dewey Beach work calendar at a glance. Confirm current rules with the town before scheduling.

Materials Worth the Money One Block From the Ocean

Salt air is relentless. A hundred yards from the surf, the difference between a house that looks new at year twelve and one that looks tired at year five is almost entirely a materials and detailing decision made during design.

The items that repay their premium are consistent: stainless or hot-dipped galvanized structural connectors, marine-grade hardware on anything exposed, fiber cement or genuine cedar over composites that chalk, impact-rated glazing, and mechanical equipment mounted high and specified for coastal service. Cheap fasteners in an expensive house are the most common false economy on this coast. Detailing matters as much as product selection — flashing at every penetration, ventilated cladding assemblies and rinseable hardware extend service life without changing how the house looks. Our guide to coastal home building materials in Delaware goes deeper on the tradeoffs.

Budgeting Realistically for a Dewey Lot

We do not publish a cost-per-square-foot figure for a coastal build, because the number moves with the flood zone, pile count, lot access and finish level. What we can say is where this budget diverges from an inland one: site and structure carry a larger share. Pile foundations, elevated utility runs, engineered connections and the stair or elevator reaching the living level are costs an inland house does not have. Staging is tighter, deliveries slow in season, and the buildable footprint is usually smaller.

On the other side of the ledger, Delaware has no state sales tax on materials, a real advantage at this project size — we broke that down in why building in Delaware costs less. Financing also works differently on a ground-up build, and our overview of construction loans in Delaware covers how draws are structured. Still deciding between commissioning a design and buying something already built? The comparison in custom home versus spec home is a useful place to start.

What to Confirm Before You Buy a Dewey Beach Lot

Verify the site’s constraints before the contract goes hard. Nearly everything that determines whether a lot can carry the house you want is public information, and none of it should be assumed from the listing.

  • Flood zone and base flood elevation for that parcel, from the current FIRM rather than a neighbor’s certificate.
  • Zoning district and bulk standards — lot area, setbacks, coverage and maximum height — from the town’s current zoning tables.
  • Utility connections and stormwater requirements for water, sewer and drainage.
  • Access and staging, since a tight lot on a narrow street changes how the build is sequenced.
  • Recorded restrictions on the deed or community that sit on top of the town code.

Confirm these directly with the Town of Dewey Beach Building and Zoning Department, the office that issues the permit. Rules change, and a builder quoting what the code said three years ago is not helping you. For the county layer alongside the town process, see Sussex County building permits, and for the wider coastal picture, building in a Delaware flood zone.

Building in Dewey Beach With CRx

CRx Construction has spent decades building and remodeling on this stretch of the Delaware coast, and Dewey is one of the towns we build in regularly. Dion Lamb leads every project personally, and the work runs on The 5 Simple Steps™ — a collaborative process that puts site analysis, the design team and the budget in one conversation before drawings are finalized, so the constraints above shape the house instead of ambushing it.

The same approach drives our work as Delaware custom home builders across Sussex County. If your project is an existing property rather than a new build, our Dewey Beach remodeling guide is the better starting point, and finished work is in our portfolio.

Common Questions

Dewey Beach Custom Home FAQ

Is the whole town of Dewey Beach in a flood zone?

+

Most of the town sits in a Special Flood Hazard Area under FEMA community number 100056. It includes both VE coastal high-hazard areas and AE zones, and the requirements differ. Pull the flood determination for your specific parcel rather than assuming it matches the property next door.

What is freeboard and why does Dewey require two feet of it?

+

Freeboard is height built in above the mapped base flood elevation as a safety margin. Dewey Beach adopted a two-foot requirement in October 2024. It protects against surge exceeding the modeled flood and lowers insurance premiums, since rates depend heavily on how far the lowest floor sits above base flood elevation.

Can I put a finished room under an elevated Dewey Beach house?

+

No. Enclosed space below the lowest floor is limited to parking, building access and storage. Living space and mechanical equipment are not permitted there. In coastal high-hazard areas, any walls below the elevated floor must also be designed to break away under flood loads rather than transfer them into the structure.

Can I bring in fill dirt to raise my lot instead of using pilings?

+

Not in a coastal high-hazard area. Town code expressly prohibits placing structural fill for the purpose of elevating buildings in the VE zone. Elevation there is achieved with pilings or columns, anchored and embedded deep enough to account for the soil that storm scour is expected to remove.

How long is a Dewey Beach building permit valid?

+

A building permit is valid for one year from the date of issue and may be renewed once for an additional year, provided the renewal is applied for before the permit expires. On a project that pauses for a seasonal restriction, tracking that expiration date matters more than it does on an inland build.

When can crews work on my house in Dewey Beach?

+

Construction activity is prohibited between 6:00 p.m. and 8:00 a.m. every day. Saturday work is permitted from 9:00 a.m. to 6:00 p.m., but only from September 16 through May 14. Sundays and state holidays are not permitted. Verify the current schedule with the town before finalizing a construction timeline.

Does the summer restriction stop my project entirely?

+

No. The seasonal prohibition targets pile driving, which is barred from the Thursday evening before Memorial Day until the Tuesday morning after Labor Day. Other trades continue within permitted hours. The practical effect is that foundation work should be complete before mid-May or planned to resume in the fall.

Should I choose an elevator or a stair on a narrow Dewey lot?

+

It depends on lot width and how long the household plans to keep the house. A compliant stair from grade to an elevated living level consumes real footprint on a tight parcel, and an elevator shaft sometimes costs less usable area. Many coastal plans include both, with the elevator sized for luggage and groceries.

What does an elevation certificate do for me?

+

It documents the finished height of the lowest floor relative to base flood elevation. Insurers use it to rate the policy, and it proves the home was built to the elevation the permit required. Keep the original with your closing documents; you will be asked for it repeatedly.

How early should I involve a builder in a Dewey Beach project?

+

Before the lot is under contract, if possible. Flood zone, base flood elevation, district bulk standards and site access determine what can be built and what it will cost. A feasibility review at that stage is inexpensive compared with redesigning a plan that never fit the parcel to begin with.

Start the Conversation

If you are considering building a custom home in Dewey Beach, the earlier the site analysis happens, the more design freedom you keep. CRx Construction will walk the lot with you, review the flood and zoning constraints, and help you understand what the parcel can carry before you commit to a plan. Schedule an Idea Session to talk through your project.

Your First Simple Step

The Idea Session

Our design team is ready to help you identify your space needs, design preferences, and personal touches to create your perfect plan. Together we will establish the scope and budget for your project.
Dion Lamb, Founder and President of CRx Construction

Or Call Dion Lamb

Congratulations, VIP!

You’ve secured your spot! We’re emailing you everything you need to know for our October Open House of 11 Persea St.



SHARE:

Facebook
LinkedIn
X
Email

WAIT! BEFORE YOU GO...

We'd like to offer you this Free Download:

What are the questions you should know before building on your own plot of land? Here we detail what every land owner should know – everything from zoning, environmental, and water drainage to other factors unique to this type of purchase and more.

Start Your Dream Home Journey With Our Helpful Guides!
